Process · Design & engineering

From the first drawing to dispatch

Every order walks the same road, from the first drawing to the lorry. These are the stages, who signs each one off, and what is checked before it moves.

3 hold points: nothing moves on until you approve it.

  1. 01 · planning

    Brief

    A drawing, a reference, a photograph or a sentence. We ask what the piece is for before we ask what it is made of.

    Comes in
    • Your drawing, sketch, reference photograph or a sentence
    Checked
    • What the piece has to do, and where it lives
    • Whether it is interior, exterior or a wet area
    • Rough sizes, quantities and when it is needed on site
    You receive
    • An honest answer on whether it is buildable
    • A first indication of cost and timeline
    Approval

    The workshop.

  2. 02 · planning

    Sample

    The finish is decided in the hand, on the metal you are considering. The approved sample becomes the standard the batch is measured against.

    Verdigris patina sample labelled MT-02, held in the workshop
    Comes in
    • An honest answer on whether it is buildable
    • A first indication of cost and timeline
    Checked
    • The finish is seen on the actual metal, not on a screen
    • The sample is agreed in the light the piece will live in
    You receive
    • A physical sample, approved and kept
    • The standard every piece in the batch is compared against
    Approval

    Yours. Nothing moves on until you sign this off.

  3. 03 · planning

    Shop drawings

    Sections, joints, fixings and tolerances resolved on paper and issued for your approval before anything is cut.

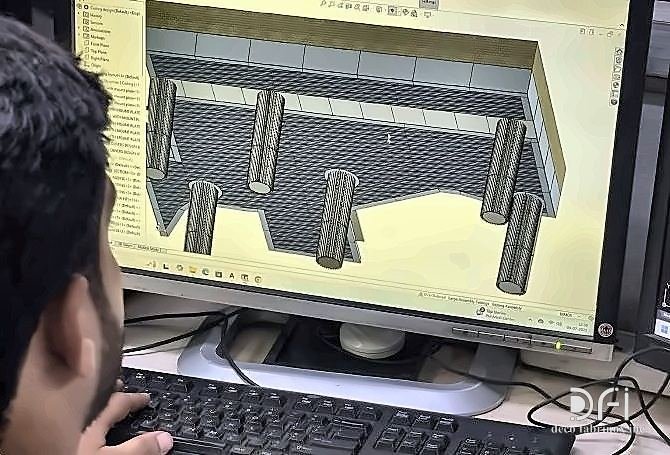

    Fabrication drawing being nested on a workstation
    Comes in
    • A physical sample, approved and kept
    • The standard every piece in the batch is compared against
    Checked
    • Sections, joints and fixings resolved
    • Sizes checked against the opening on site
    • Issued for approval before any metal is cut
    You receive
    • Drawings issued for your approval
    • A cutting list, once the drawings come back approved
    Approval

    Yours. Nothing moves on until you sign this off.

  4. 04 · production

    Production planning

    The approved drawing becomes a cutting list, a material order and a place in the workshop schedule, under one job number.

    Comes in
    • Drawings issued for your approval
    • A cutting list, once the drawings come back approved
    Checked
    • Material ordered against the approved drawing
    • The job is scheduled against the date promised
    • One job number follows the work from here to dispatch
    You receive
    • A cutting list and a material order
    • A production schedule for the job
    Approval

    The workshop.

  5. 05 · production

    Workshop

    CNC cutting, forming, welding and hand craftsmanship under one roof, against the approved drawing and sample.

    Five-axis CNC press brake set up for metal forming
    Comes in
    • A cutting list and a material order
    • A production schedule for the job
    Checked
    • Each piece is cut and formed to the approved drawing
    • Welds are dressed before the piece moves on
    • Work is checked against the drawing at each bench
    You receive
    • The piece, fabricated and ready for finishing
    Approval

    The workshop.

  6. 06 · production

    Finishing

    The approved sample comes back out and the piece is finished against it, on the same metal it was agreed on.

    Buffing wheel polishing a metal surface by hand
    Comes in
    • The piece, fabricated and ready for finishing
    Checked
    • The finish is compared against the approved sample
    • Colour and grain run consistently across the batch
    • The surface is protected before it is packed
    You receive
    • The piece, finished to the approved sample
    Approval

    The workshop.

  7. 07 · quality

    Final check

    The finished piece is measured against the drawing and compared against the sample one last time, before anything is packed.

    Checking a folded stainless steel part with a vernier caliper
    Comes in
    • The piece, finished to the approved sample
    Checked
    • Sizes measured against the approved drawing
    • Finish compared against the approved sample
    • Fixings and loose parts counted against the list
    • Photographs taken of the finished work
    You receive
    • A checked piece, cleared for packing
    • Photographs of the work as it leaves
    Approval

    Yours. Nothing moves on until you sign this off.

  8. 08 · dispatch

    Packing, delivery and site

    Packed for the journey it actually has to make, then delivered, installed and checked against the drawing by the people who made it.

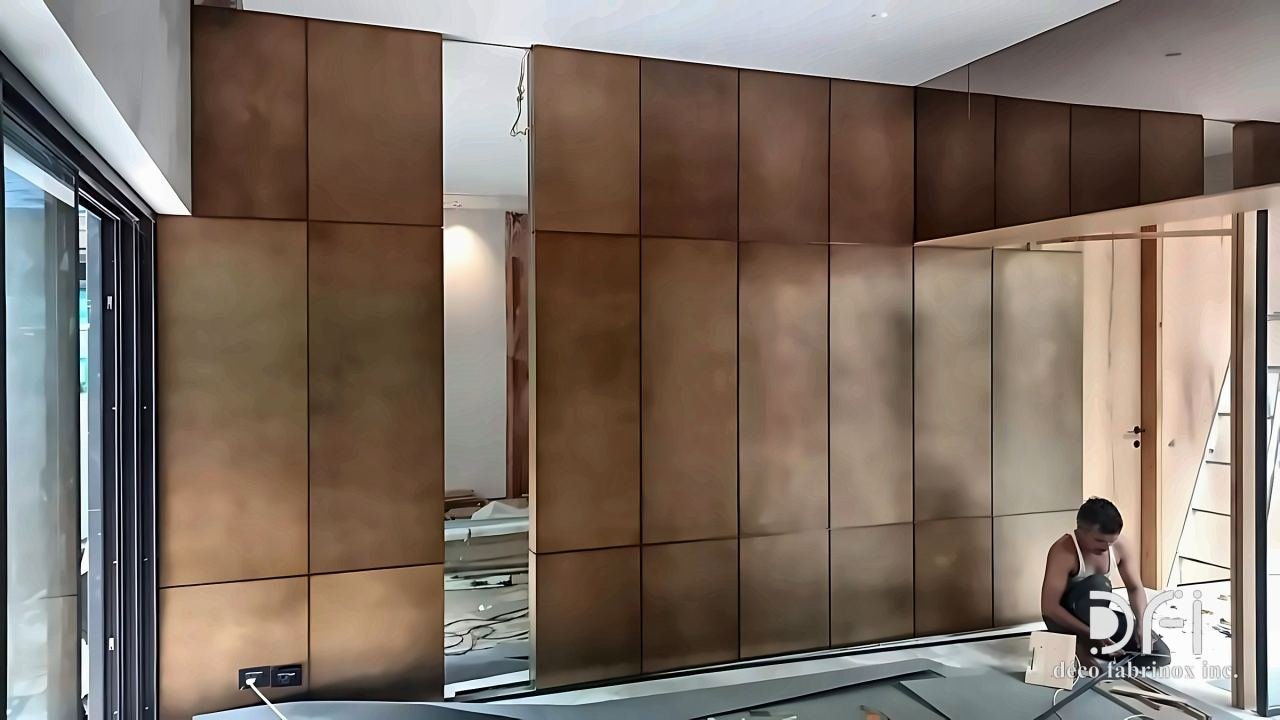

    Bronze cladding panels on a long wall during installation
    Comes in
    • A checked piece, cleared for packing
    • Photographs of the work as it leaves
    Checked
    • Packed for the journey, not just for the warehouse
    • Every item on the dispatch note is in the crate
    • Checked against the drawing again once it is up
    You receive
    • A dispatch note listing what was sent
    • The piece installed and checked on site
    Approval

    The workshop.

What we do for every order, whatever its size

A single job number follows the work from the first drawing to the dispatch note. Nothing leaves a bench until the stage before it has been signed off.
